Our Insights
Loutsis Creek Fish Passage - Duvall, Washington (2020)
Enhancing Fish Passage with Composite Bridge Design
Project Highlights & Key Takeaways
- Bridge System: Composite arch bridge using Fiber-Reinforced Polymer (FRP) tubes by Basalt International
- Project Goal: Replace a 5-ft concrete culvert with a 51-ft composite span to restore fish passage
- Habitat Restored: 3.1 miles of upstream habitat for Coho salmon, steelhead, and cutthroat trout
- Installation Speed: SR 203 reopened in 34 days-half the time of comparable steel/concrete projects
- Sustainability: Reduced concrete by ~90% and incorporated Type 1L low-carbon cement
- Carbon Impact: Lightweight FRP materials cut transport emissions and equipment needs
Key Stakeholders
- Owner: Washington State Department of Transportation (WSDOT)
- Contractor: Goodfellow Bros., Inc. (GBI)
- Material & Technology Supplier: Basalt International
- Ecosystem Impact: Restored 3.1 miles of upstream habitat for Coho salmon, steelhead, coastal cutthroat trout
Recognition & Performance
- Received AGC/WSDOT Honorable Mention and ASCE Local Civil Engineering Achievement awards
- 100-year service life with minimal maintenance and no corrosion
Project Summary
The Loutsis Creek Fish Passage project replaced an outdated concrete culvert beneath State Route 203 with an advanced composite-arch bridge system supplied by Basalt International. The transformation unlocked vital habitat, minimized traffic disruption, and delivered a high-performance infrastructure solution. The project cost approximately $4 million.
Challenge: Legacy Barrier to Fish Migration
- A 5-foot-diameter concrete culvert embedded ~40 ft beneath the roadway blocked migrating fish in the Snoqualmie River watershed.
- Thousands of similar culverts across Washington fragment aquatic habitats, hinder fish passage, and contribute to ecological decline.
- Conventional culverts prioritize drainage over ecosystem function-resulting in unnatural flows, sediment issues, and mobility barriers for fish.
Solution: Composite Arch Bridge System by Basalt International
Innovation in design and materials:

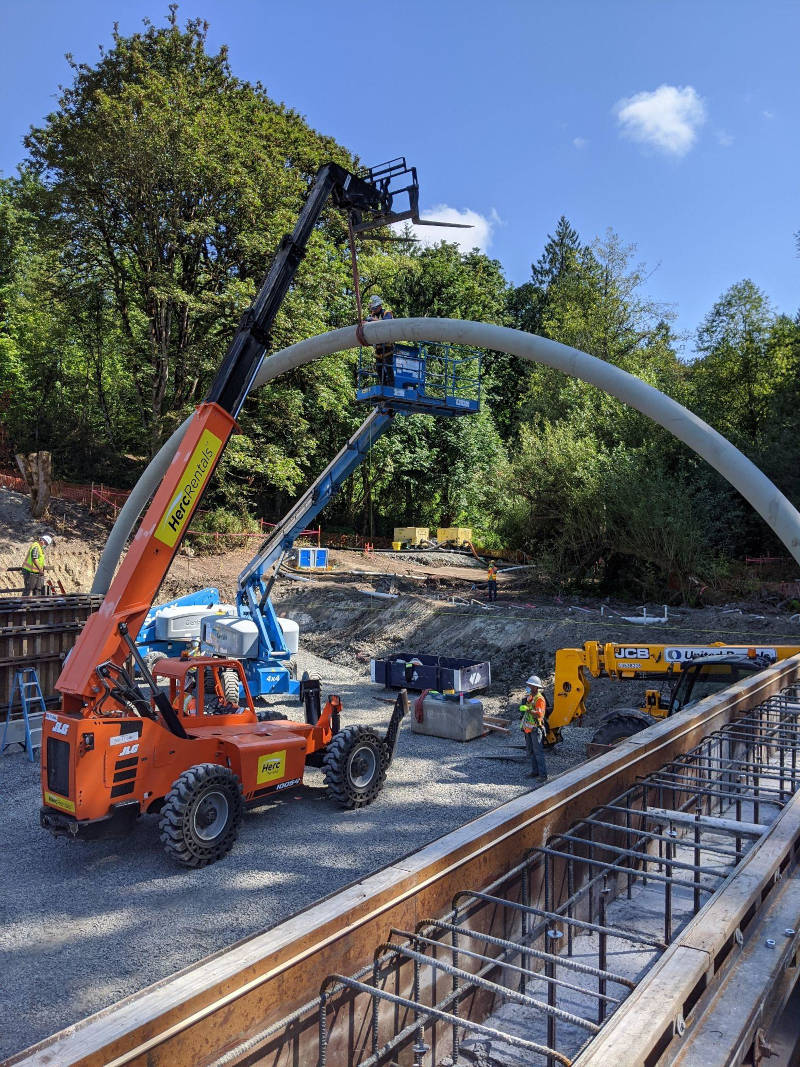

- The system uses lightweight FRP (Fiber-Reinforced Polymer) tubes, each weighing approx. 300 lbs, allowing manual or forklift-based handling instead of heavy cranes.

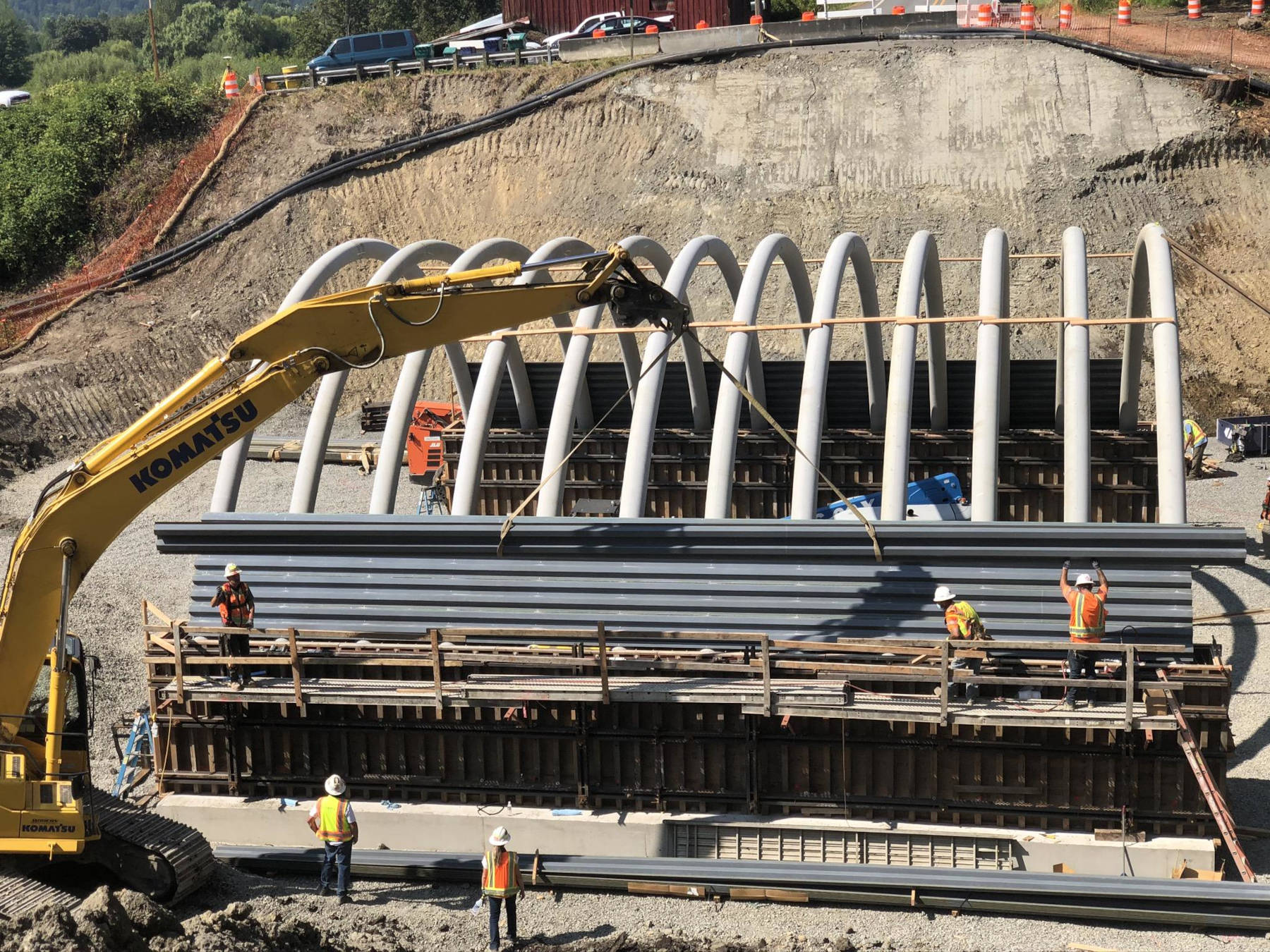

- Transport logistics optimized: The arch structure was delivered in segments to avoid oversize permit issues. Assembly and installation occurred within 24 hours.

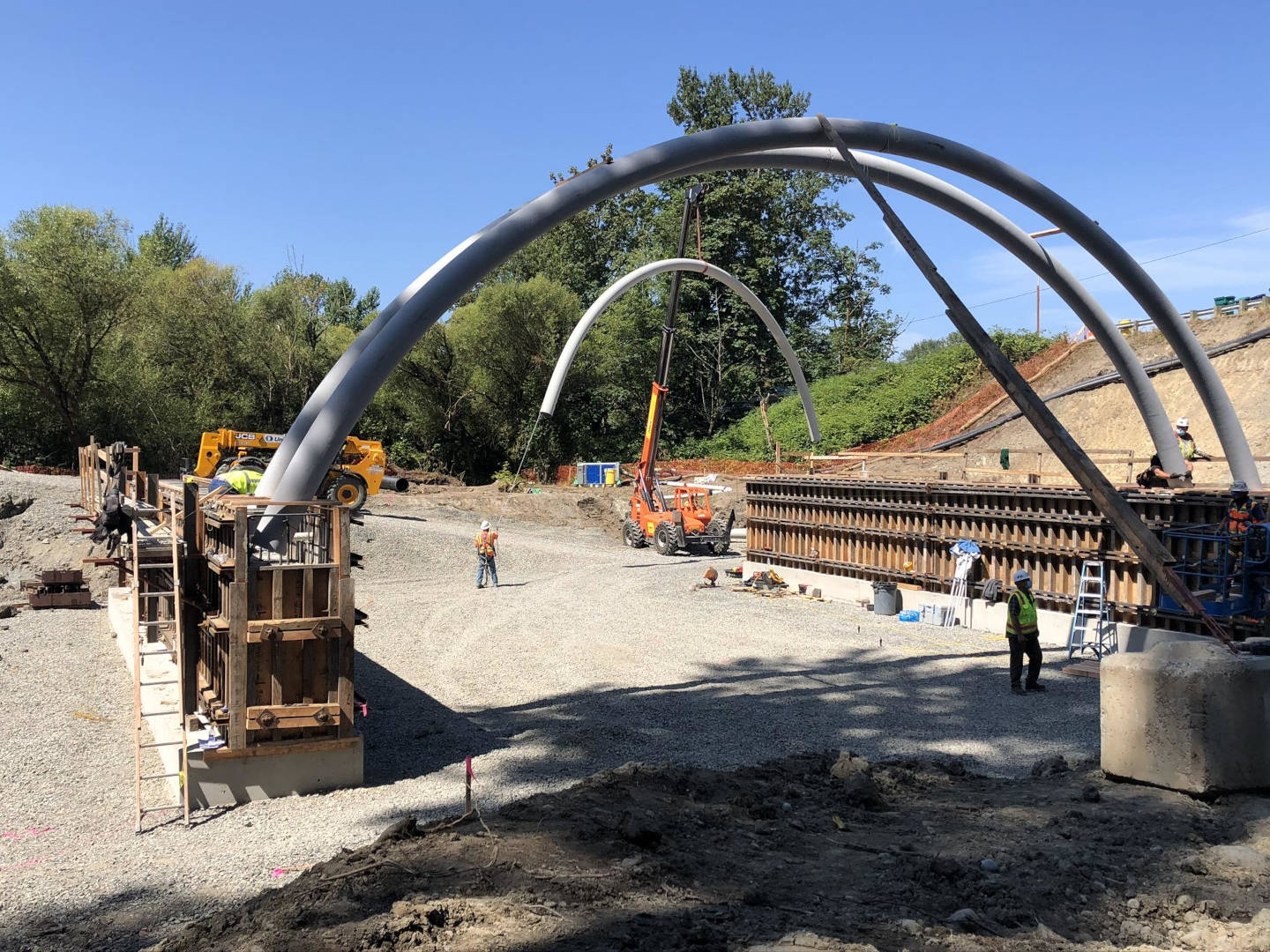

- Span: A 51-ft wide bridge replaced the original ~6-ft span, enabling restoration of a natural floodplain and habitat corridor.

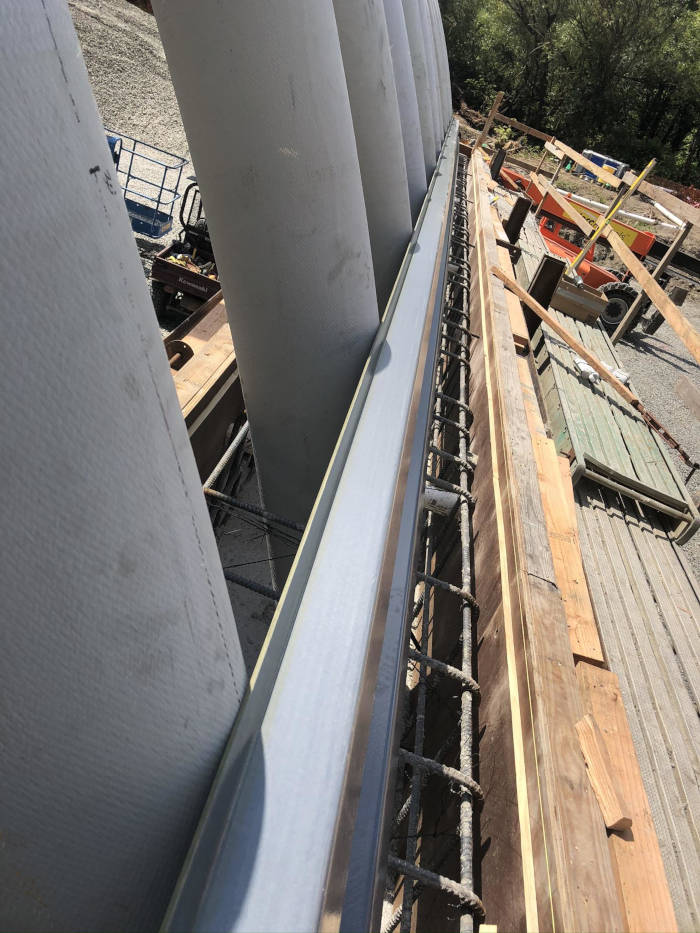

- On-site technical support from Basalt International ensured precision during tube installation, decking application, and concrete fill.
Sustainability & Performance Highlights

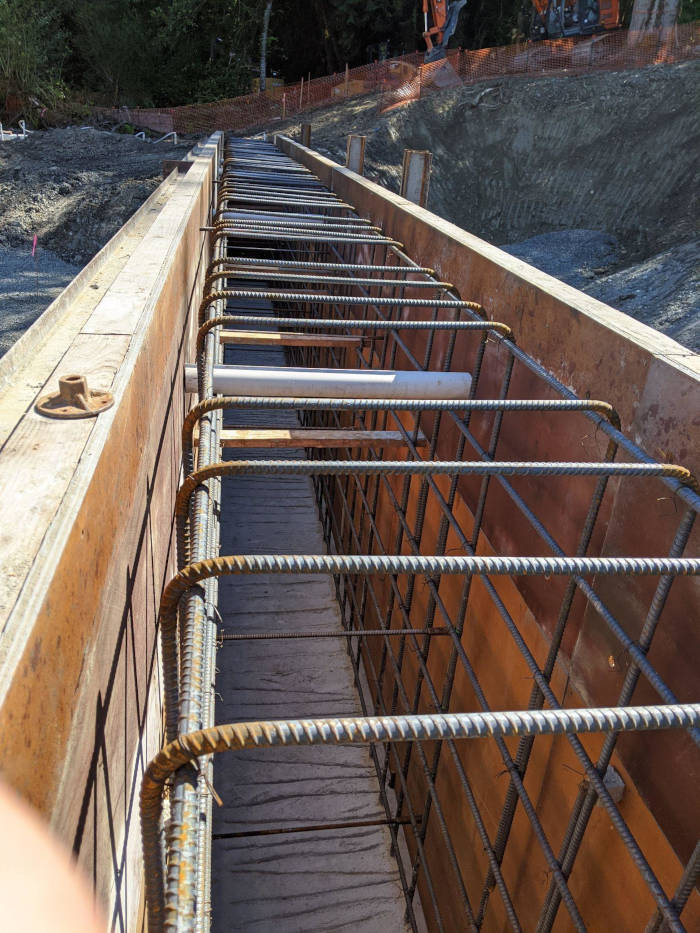

- Concrete usage reduced to ~10% of what a conventional buried arch would require.
- Adaptation of Type 1L low-carbon cement in fill reduced embodied carbon while maintaining performance.
- Project re-opened SR 203 after just 34 days-significantly shorter than comparable structures (60+ days).
- Composite system projected service life exceeds 100 years, with minimal maintenance.
- Enhanced resilience: corrosion resistance, seismic adaptability, reduced soil-settlement risk.
Differentiation vs. Traditional Structures
| Feature | Conventional Buried Arch | Basalt International Composite Arch |
|---|---|---|
| Installation time | 60+ days | 34 days |
| Corrosion/maintenance | Susceptible | Corrosion-resistant, minimal upkeep |
| Carbon footprint | High (Portland cement intensive) | Low (FRP + low-carbon concrete) |
| Lifecycle | ~50-75 years | 100+ years |
| Transport weight | Heavy / oversize | Lightweight / permit-free |
Outcome & Impact

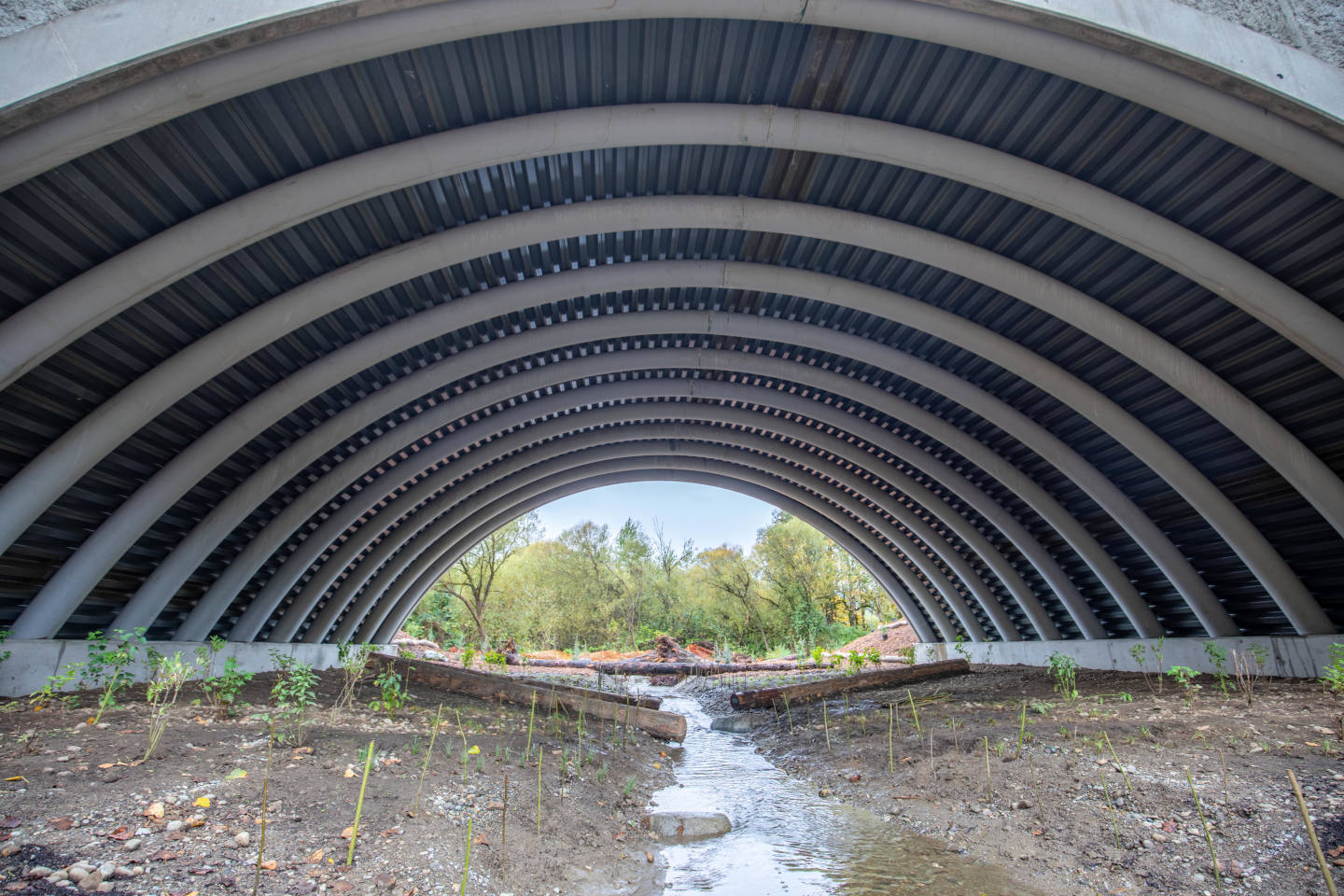

- Restored 3.1 miles of upstream fish habitat.
- Traffic reopened in 34 days-reducing user-delay and community disruption.
- Recognitions: Honorable Mention (AGC/WSDOT) and ASCE Local Outstanding Civil Engineering Achievement (Structures).
- WSDOT has since replicated insights from this project across dozens of high-priority fish-passage sites.
Conclusion
The Loutsis Creek project-with Basalt International's Composite Arch Bridge System at its core-demonstrates how engineered materials and ecosystem restoration can converge. With a lightweight design, low-carbon materials, and streamlined installation, the project offers a blueprint for sustainable infrastructure that supports both mobility and biodiversity.
